Why Your Power Bank Supplier Quotes "Approximately 4 Weeks" But Your USB Drive Supplier Quotes "December 15"

Why Your Power Bank Supplier Quotes "Approximately 4 Weeks" But Your USB Drive Supplier Quotes "December 15"

When a Singapore procurement team receives quotes for two corporate tech gift orders in the same week, the contrast in delivery commitments can be jarring. The USB flash drive supplier confidently states "Delivery on December 15"—a specific date, no hedging. The power bank supplier, working with similar order quantities and similar lead times, responds with "Approximately 4 weeks from purchase order confirmation." The immediate interpretation is often that the USB supplier is more professional, more confident in their operations, or simply more willing to commit. The power bank supplier, by contrast, appears evasive or uncertain.

In practice, this is often where lead time assessment decisions start to be misjudged. The difference between a date-specific quote and a range-based quote has little to do with supplier confidence or operational maturity. It reflects something more fundamental: the structure of the production workflow itself. Some products, by their very nature, can be scheduled to a specific date. Others cannot, regardless of how sophisticated the factory's planning systems might be. Understanding this distinction matters because it determines which delivery commitments are realistic to expect, which products can be tied to fixed event dates, and where procurement teams should build additional buffer time into their planning.

The assumption that "approximately 4 weeks" signals supplier hesitancy becomes problematic when it leads procurement teams to push for more precise timelines that the production process cannot structurally deliver. The factory isn't being vague—they're being accurate about the inherent uncertainty in their workflow. Pressing for a specific date in these cases doesn't improve reliability; it just forces the supplier to add extra buffer time to avoid missing a commitment they know they cannot guarantee. The result is often a longer quoted lead time than if the range-based estimate had been accepted in the first place.

Linear workflows and deterministic scheduling

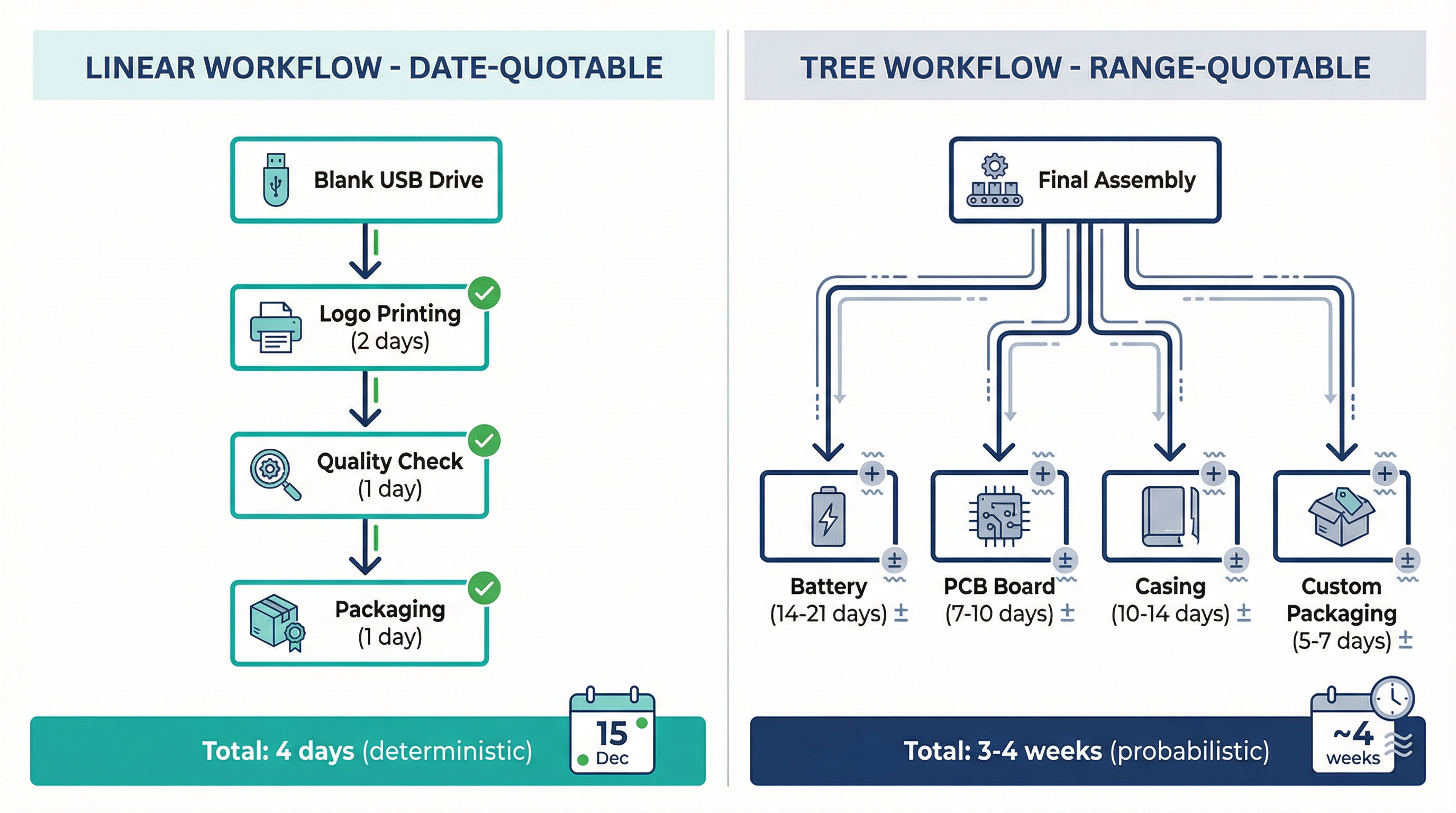

A USB flash drive with logo printing follows what can be described as a linear workflow. The production sequence is strictly sequential: blank drives are procured, logo artwork is applied through pad printing or laser engraving, units pass through quality control, and finished products are packaged. Each step depends only on the completion of the previous step. There are no parallel processes that need to converge, no multiple suppliers whose deliveries must align, and no complex assembly sequences where timing mismatches create bottlenecks.

This linear structure makes the timeline deterministic in a way that allows for date-specific quoting. If the blank drives are in stock, the printing process takes two days, quality control requires one day, and packaging takes another day, the factory can confidently commit to a four-day turnaround. The only variables are known quantities—machine availability, staff scheduling, and standard process times. Even if one step takes slightly longer than planned, the delay is measurable and can be absorbed within the quoted timeline or communicated early enough to adjust expectations.

The key characteristic that enables date-specific quoting is the absence of dependency convergence. In a linear workflow, delays are additive but predictable. If printing takes an extra half-day, the delivery date shifts by half a day. There's no multiplication effect, no cascading uncertainty, and no scenario where multiple small delays compound into a much larger overall delay. For Singapore procurement teams managing corporate events or product launches with fixed dates, this makes certain product categories—custom USB drives, simple phone accessories, basic promotional items—suitable for time-sensitive commitments.

Tree workflows and probabilistic uncertainty

A custom power bank with branded packaging operates under a fundamentally different production structure. The workflow is not linear but tree-shaped: multiple parallel processes must all complete before final assembly can begin. The battery cells need to be sourced and tested, the printed circuit board must be manufactured and programmed, the outer casing requires tooling and molding, and the custom packaging has to be designed, approved, printed, and die-cut. Each of these parallel branches has its own lead time, its own supplier, and its own potential for delay.

This tree structure introduces what can be called dependency convergence risk. Final assembly cannot begin until all components arrive. If the battery supplier delivers in 14 days, the PCB in 10 days, the casing in 12 days, but the packaging is delayed to 16 days, the entire project waits for the slowest component. The overall lead time is not the average of the component lead times—it's determined by whichever branch takes longest. This creates a mathematical problem: even if each individual supplier has a 90% on-time delivery rate, the probability that all four suppliers deliver on time simultaneously is only 66% (0.9^4). The more parallel dependencies exist, the lower the probability of hitting a specific date.

The uncertainty compounds further when each branch itself contains sub-dependencies. The battery supplier might be waiting on cells from a manufacturer in South Korea, whose delivery time depends on customs clearance that can range from two to seven days. The PCB fabrication might require components that are currently on backorder, with restocking dates that are themselves estimates. The packaging printer might be dependent on a specific cardstock that ships from Europe, subject to freight delays. Each of these sub-dependencies adds another layer of probabilistic uncertainty that cannot be eliminated through better planning—it's inherent to the structure of the supply chain.

This is why the power bank supplier quotes "approximately 4 weeks" rather than "December 15." They're not hedging or being cautious. They're acknowledging that the production workflow contains too many probabilistic nodes to commit to a specific date without adding so much buffer time that the quote becomes uncompetitive. The range-based estimate reflects the actual distribution of possible outcomes given the dependency structure. Asking for a more precise timeline in this scenario is asking the supplier to either lie about their certainty or pad the estimate to the point where it covers the worst-case scenario across all branches.

What makes a product date-quotable

The distinction between date-quotable and range-quotable products is not arbitrary. Certain structural characteristics determine whether a factory can realistically commit to a specific delivery date. Products that source all components from a single supplier or maintain them in inventory eliminate the convergence risk that comes from coordinating multiple external dependencies. If the factory controls the entire supply chain internally, delays become visible early and can be managed proactively rather than discovered only when a component fails to arrive on schedule.

Products with established, high-volume processes also tend to be more date-quotable because the statistical variation in production time is well understood. A process that has been run thousands of times has predictable cycle times, known defect rates, and established quality control procedures. The factory can quote with confidence because they have historical data showing that 95% of orders complete within a specific timeframe. New or low-volume products lack this statistical foundation, making any timeline estimate more speculative.

The absence of client approval checkpoints is another factor that enables date-specific quoting. When a product requires sample approval, artwork confirmation, or pre-production inspection, each checkpoint introduces a delay whose duration depends on the client's internal processes. A sample might be ready in three days, but if the client takes a week to review and request revisions, the overall timeline extends unpredictably. Factories cannot control client response times, so they cannot commit to dates that depend on them. This is why fully standardized products with no customization beyond logo placement are easier to schedule precisely than products requiring iterative design approval.

For Singapore procurement teams, understanding these structural factors helps set realistic expectations. If a corporate gift order involves multiple customization layers—custom battery capacity, unique casing design, branded packaging, and pre-loaded software—the supplier's reluctance to commit to a specific date is not a red flag. It's an honest assessment of the dependency structure. Pushing for a date-specific commitment in such cases typically results in either an inflated lead time (to cover worst-case scenarios across all dependencies) or a missed deadline when any single branch encounters delays.

The mathematics of uncertainty propagation

The reason tree workflows cannot be scheduled as precisely as linear workflows comes down to how uncertainty propagates through different structures. In a linear sequence, uncertainties are additive. If step A takes 2±0.5 days and step B takes 3±0.5 days, the total time is 5±1 days. The range of possible outcomes grows, but it grows in a predictable, bounded way. The worst-case scenario is the sum of the worst-case times for each step.

In a tree structure, uncertainties compound multiplicatively. Consider a power bank assembly that requires four parallel components, each with a quoted lead time that has a ±20% variance. If each component has a 90% probability of arriving within the quoted window, the probability that all four arrive on time is 0.9^4 = 66%. There's a one-in-three chance that at least one component will be late, and when that happens, the entire project waits. The overall timeline variance is not ±20%—it's significantly wider because the slowest branch determines the completion date.

This mathematical reality explains why factories quote ranges for complex products even when they have excellent supplier relationships and sophisticated planning systems. The uncertainty is not a function of poor management; it's a function of workflow structure. A factory producing custom wireless chargers with five parallel component streams cannot quote a specific date with the same confidence as a factory printing logos on pre-manufactured phone stands, even if both factories have identical operational efficiency and supplier reliability.

For procurement teams evaluating quotes, this has practical implications. When a supplier provides a range-based estimate for a product with multiple dependencies, the appropriate response is not to demand a more precise timeline but to understand where in that range the most likely outcome falls and what factors could push the delivery toward the longer end. Asking "What are the main variables that could extend this to four weeks instead of three?" is more useful than asking "Can you commit to a specific date?" The former question helps with risk planning; the latter just forces the supplier to quote conservatively to avoid penalties.

Singapore procurement implications and event planning

The structural difference between date-quotable and range-quotable products becomes particularly relevant for Singapore corporate buyers managing tech gifts for fixed-date events—annual dinners, conference giveaways, client appreciation programs, or new year corporate gifting. When an event date is immovable, the procurement timeline must work backward from that date, and the choice of product category determines how much buffer time is realistically needed.

Products with linear workflows—custom USB drives, simple phone accessories, basic branded tech items—can be scheduled closer to the event date because their delivery timelines are more predictable. A procurement team might reasonably place an order four weeks before an event with confidence that a specific delivery date can be met. Products with tree workflows—power banks, wireless chargers with custom packaging, multi-component tech gift sets—require longer buffers not because the average lead time is necessarily longer, but because the variance in possible outcomes is wider.

This is where the distinction between average lead time and reliable lead time matters. A power bank supplier might say "most orders complete in 3-4 weeks," but if the procurement team needs certainty for a December 10 event, they should be planning based on the upper end of that range, not the average. The factory's range-based quote is already accounting for the probabilistic nature of their workflow. Treating "approximately 4 weeks" as "probably closer to 3 weeks" introduces risk that could have been avoided by understanding the structural reasons for the range in the first place.

For procurement teams working with multiple suppliers across different product categories, this also suggests a portfolio approach to risk management. If an event requires both USB drives and power banks, the USB drives can be ordered closer to the deadline because their timeline is more deterministic. The power banks should be ordered earlier, with buffer time built in to account for the tree workflow structure. This isn't about trusting one supplier more than another—it's about matching procurement timelines to the inherent characteristics of different production workflows and understanding how production schedules accommodate products with different dependency structures.

When precision is structurally impossible

There are scenarios where even range-based estimates become difficult to provide with confidence, and these typically involve products where the dependency tree is not just wide but also deep—meaning each branch itself contains multiple sub-branches with their own uncertainties. A fully custom tech product—say, a branded portable fan with proprietary battery specifications, custom motor housing, unique blade design, and specialized packaging—might have component lead times that are themselves estimates rather than confirmed timelines.

In such cases, the factory might quote "6-8 weeks" but with the caveat that this assumes no major delays in component sourcing. The range is wider, and the confidence level is lower, because the number of variables that could affect the timeline is simply too large to model precisely. This is not a sign of poor planning—it's an acknowledgment that certain products have supply chains complex enough that deterministic scheduling is structurally impossible without carrying massive inventory buffers at every stage.

For Singapore procurement teams, recognizing when a product falls into this category helps avoid unrealistic expectations. If a supplier quotes a wide range and explicitly notes that component availability could affect the timeline, the appropriate response is to either accept the uncertainty and plan accordingly, choose a simpler product with a more predictable workflow, or work with the supplier to identify which specific components carry the most risk and whether alternatives exist that could reduce dependency complexity.

The key insight is that lead time precision is not always a matter of supplier capability or willingness to commit. Sometimes it's a matter of production structure. Linear workflows enable date-specific quotes. Tree workflows require range-based estimates. And highly complex, multi-tier dependency trees may not support confident estimates at all without significant buffer time. Understanding which category a product falls into—before placing the order—helps procurement teams set realistic timelines, choose appropriate products for time-sensitive events, and avoid the frustration that comes from expecting precision where the production structure cannot deliver it.
