Why Your Custom Tech Gift Lead Time Is Locked to One Factory (And Why Switching Costs 3x the Time)

📱
Article Featured Image

When buyers evaluate lead time for custom tech gifts like branded USB drives or power banks, they typically compare quotes from multiple factories: "Factory A says 4 weeks, Factory B says 6 weeks." The decision seems straightforward—choose the faster option. But this comparison fundamentally misunderstands how lead time works once custom tooling enters the equation. The moment a factory invests in molds, dies, or fixtures specific to your product, your lead time is no longer a standalone variable. It becomes conditional: 4 weeks if you stay with that factory, potentially 12 weeks if circumstances force you to switch.

This is the tooling lock-in effect, and it represents one of the most consequential—yet least discussed—aspects of lead time planning in custom manufacturing. Buyers routinely ask about production timelines but rarely ask the more revealing question: "What happens to my lead time if I need to switch suppliers after tooling is completed?" The answer exposes a structural reality that changes how lead time should be evaluated from the outset.

Consider a typical scenario. A company orders 5,000 custom-molded power banks with their logo embossed on the casing. The factory quotes 4 weeks lead time, which includes tooling fabrication (1 week), sampling and approval (1 week), and mass production (2 weeks). The buyer approves the sample, production begins, and everything proceeds as planned. But what if, three weeks into production, the factory encounters a capacity issue and can only deliver half the order on time? Or what if quality problems emerge that can't be resolved quickly? The buyer's instinct is to ask: "Can we move the remaining quantity to another factory?"

This is where the conditional nature of lead time becomes apparent. Moving to a new supplier doesn't mean starting from week 3 of the original timeline. It means starting from week 0 of an entirely new timeline—one that's significantly longer than the original quote. The new factory needs to either receive the existing tooling (if the buyer owns it) or fabricate new tooling from scratch (if the original factory owns it). Even in the best case, where tooling is buyer-owned and can be transferred, the new supplier requires 2-3 weeks just to familiarize themselves with the tooling, conduct trial runs, and verify that it produces acceptable parts in their equipment. If new tooling must be made, add another 3-4 weeks for fabrication and debugging.

But tooling transfer is only the first penalty. The new supplier must also go through qualification steps that can't be compressed. They need to demonstrate that their production process can meet the specifications, which typically requires producing and inspecting first article samples (1-2 weeks). If the product has any regulatory requirements—safety certifications for electronics, material compliance for items sold in certain markets—the new supplier's facility may need separate verification, adding another 1-2 weeks. Only after these steps are completed can actual mass production begin, which still takes the original 2-4 weeks depending on order size.

The cumulative effect is striking. What was originally quoted as a 4-week lead time becomes an 8-12 week lead time when switching suppliers mid-project. The switching penalty isn't just the time to make new tooling; it's the time to re-establish the entire production relationship from scratch. This is why experienced procurement teams don't evaluate lead time as a single number. They evaluate it as a range: the best-case timeline if everything goes smoothly with the chosen supplier, and the worst-case timeline if switching becomes necessary.

The ownership structure of tooling fundamentally shapes this dynamic. When buyers own the tooling, they theoretically have more flexibility—the molds can be physically moved to another factory. But "theoretically" is doing heavy lifting here. In practice, tooling transfer is rarely seamless. Molds are designed for specific injection molding machines, and what works perfectly in Factory A's equipment may require adjustment to run properly in Factory B's equipment. The new factory needs time to optimize cycle times, adjust temperatures and pressures, and verify that the output matches the approved samples. This debugging process can take as long as making new tooling, especially if the original factory provided minimal documentation about their process parameters.

When the factory owns the tooling, the situation is even more constrained. The buyer can't simply take the molds elsewhere; they must either negotiate a buyout (which the factory may refuse, especially if the relationship has soured) or commission entirely new tooling. This means the switching timeline includes 3-4 weeks for new mold fabrication before any of the qualification steps even begin. Some buyers attempt to mitigate this by contractually requiring that tooling ownership transfers to them after a certain order volume or time period. But even with ownership, the transfer penalties remain substantial.

There's also a more subtle dimension to tooling lock-in that affects lead time: the factory's prioritization of your orders. Once a factory has invested in tooling for your product, they have a sunk cost that incentivizes them to keep your business. But this cuts both ways. If your order volumes are small or irregular, the factory may delay your production runs to batch them with other jobs that use the same equipment, effectively adding 1-3 weeks of invisible wait time to your quoted lead time. You can't easily switch to another supplier to avoid this delay because switching itself takes longer than waiting. The factory knows this, which subtly shifts the power dynamic in their favor.

This dynamic becomes especially pronounced in multi-SKU orders. Suppose you're ordering three variations of a custom USB drive—different storage capacities, different colors, but the same basic form factor. Each variation requires its own tooling setup, but the factory quotes an aggregated lead time: "4 weeks for the first SKU, plus 2 weeks for each additional SKU, so 8 weeks total." This seems reasonable until you realize that the "plus 2 weeks" assumes you're staying with the same factory. If you need to split the order across multiple suppliers—perhaps because no single factory has enough capacity for all three SKUs simultaneously—each supplier needs to go through the full qualification process independently. What was quoted as 8 weeks becomes 12 weeks or more, because the parallelization you hoped for is offset by the redundant qualification steps.

The implications for procurement strategy are significant. When evaluating lead time quotes, the relevant question isn't "How long will this take?" but rather "How locked in am I to this timeline?" A factory that quotes 6 weeks but has robust capacity buffers and a track record of reliable delivery may represent a lower lead time risk than a factory that quotes 4 weeks but operates at 95% capacity with little room for error. The 4-week quote is only valid if nothing goes wrong; the 6-week quote may be more realistic when you account for the probability of needing to switch suppliers.

Some buyers attempt to hedge this risk by splitting initial orders across multiple suppliers, reasoning that if one factory encounters problems, the other can absorb the volume. But this strategy has its own lead time penalty. Each factory needs its own tooling, which means the upfront timeline is longer (you're paying the tooling fabrication time twice), and the per-unit cost is higher because neither factory benefits from the economies of scale of the full order volume. The lead time flexibility you gain comes at the cost of both time and money upfront.

Another approach is to explicitly negotiate contingency terms into the supplier agreement: if the factory can't meet the agreed timeline, they must facilitate tooling transfer to an alternative supplier at no cost to the buyer, including providing full process documentation. This doesn't eliminate the switching penalty—the new supplier still needs qualification time—but it reduces friction and ensures that the original factory can't hold the tooling hostage. However, factories are often reluctant to agree to such terms, especially for low-volume orders where the tooling investment represents a significant portion of their expected revenue from the relationship.

The most sophisticated buyers take a portfolio approach to managing tooling lock-in. For products with predictable, recurring demand, they invest in buyer-owned tooling and establish relationships with two qualified suppliers from the outset. The primary supplier handles the majority of orders, but the secondary supplier produces a small batch every few months to maintain familiarity with the tooling and process. This means that if the primary supplier encounters problems, the secondary supplier can ramp up production with minimal delay—perhaps 2-3 weeks instead of 8-12 weeks. The cost of maintaining this redundancy is the periodic small orders to the secondary supplier, but the lead time insurance it provides can be invaluable when facing tight deadlines.

For products with uncertain or one-time demand, the calculation is different. The buyer must weigh the risk of tooling lock-in against the cost of hedging strategies. If the product is for a time-sensitive campaign—a product launch, a conference giveaway, a seasonal promotion—the downside of a lead time failure is high, which justifies paying for redundancy. If the timeline is flexible, the buyer might accept the lock-in risk and simply build extra buffer time into the project schedule to account for potential switching penalties.

What makes tooling lock-in particularly challenging is that its effects aren't visible in the initial quote. A factory's lead time estimate typically assumes everything proceeds smoothly: tooling works correctly on the first try, samples are approved without revisions, production runs encounter no quality issues, and the factory's capacity remains available as planned. These assumptions are often reasonable, but they're not guarantees. The true lead time risk includes the probability-weighted cost of scenarios where things don't go smoothly, and in those scenarios, the switching penalty can dominate the timeline.

This is why experienced procurement teams maintain detailed records of supplier performance not just on nominal lead times but on lead time variability and recovery capability. A factory that consistently delivers within the quoted window, even when problems arise, demonstrates that they have internal buffers and problem-solving capacity that reduces the likelihood of needing to switch. A factory that frequently misses deadlines or requires buyer intervention to resolve issues represents a higher lock-in risk, because the probability of needing to switch—and thus incurring the switching penalty—is higher.

The broader lesson is that lead time in custom manufacturing isn't just a production parameter; it's a relationship parameter. Once tooling is invested, your lead time becomes coupled to that specific factory's capacity, priorities, and capabilities. The flexibility to switch suppliers exists in theory, but in practice, it comes with a time penalty that can be two to three times the original quoted lead time. Buyers who understand this dynamic evaluate lead time not as a single number but as a conditional variable: the best-case timeline if the relationship works smoothly, and the worst-case timeline if switching becomes necessary. The difference between these two numbers is the hidden cost of tooling lock-in, and it's often the most important lead time metric that never appears in the initial quote.

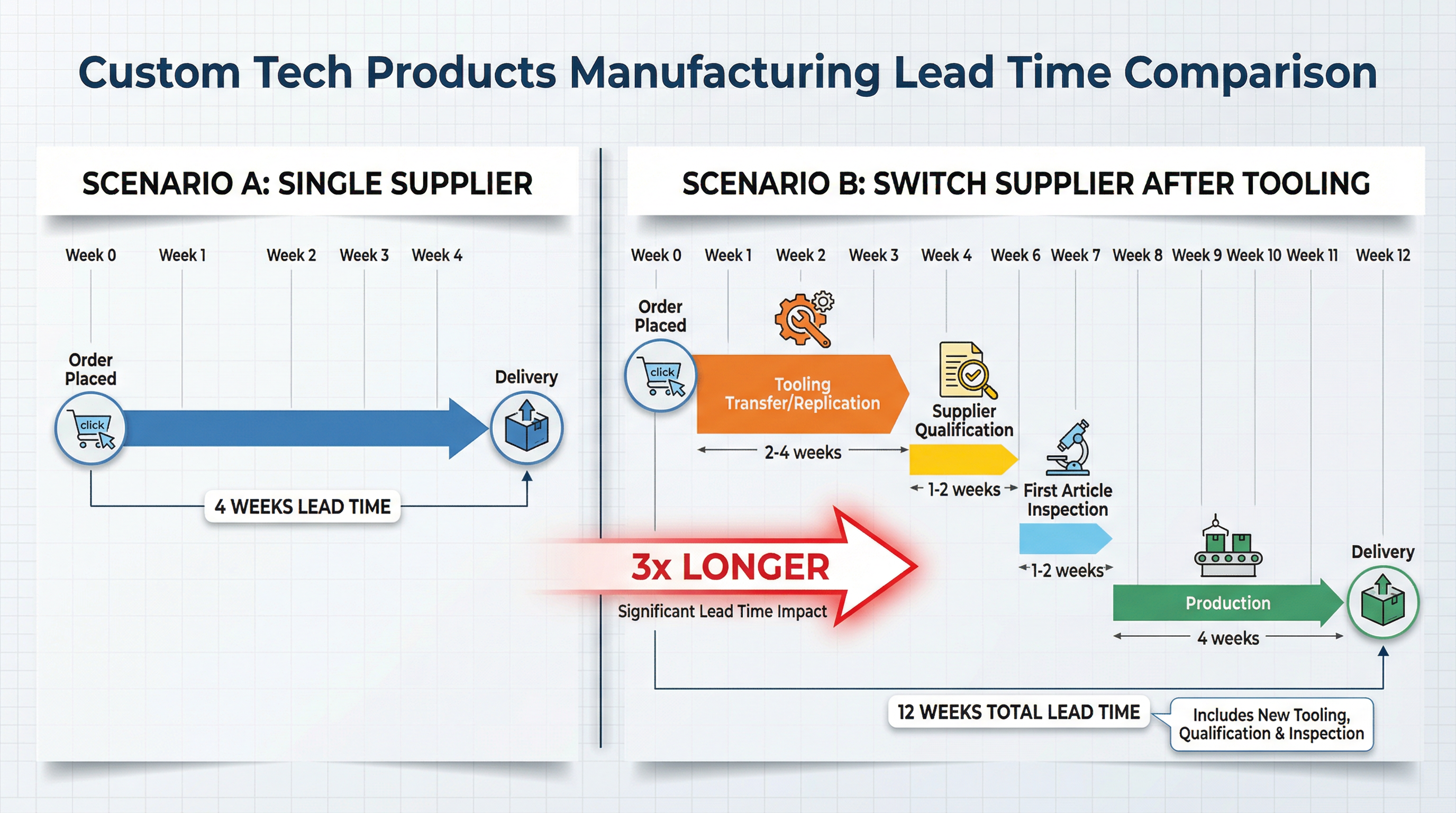

Tooling Lock-In Effect on Lead Time: Switching Penalty Comparison

When procurement teams evaluate production timelines for custom tech gifts, they need to account for not just the nominal lead time but the conditional lead time that includes switching penalties. The factories that appear fastest on paper may not be the lowest-risk choice when tooling lock-in effects are properly considered.
